Author: James Publish Time: 13-01-2026 Origin: Site
Design for lifecycle, not day-one cost: cabling should outlive active equipment by 2–3 refresh cycles.
Hybrid is the default: Cat6A for horizontal + OM4/OS2 fiber for backbone is the most common future-proof architecture.
PoE++ changes requirements: heat, bundle size, and installation quality matter as much as bandwidth.

In 2026, structured cabling is best treated as a vendor-neutral, lifecycle asset: the physical layer that supports multiple generations of switches, servers, wireless, and PoE endpoints. It is not just “cables in trays”—it is a modular architecture (entrance → equipment room → backbone → telecom rooms → horizontal → work areas) that keeps performance predictable, maintenance fast, and upgrades low-disruption.
| Subsystem | What it does | 2026 design focus |
|---|---|---|
| Entrance Facilities | Provider handoff and building entry protection | Path diversity, surge/grounding plan, labeling |
| Equipment Room | Core switching, cross-connects, backbone termination | Density, airflow, patching discipline, documentation |
| Backbone Cabling | Interconnect between rooms/floors/buildings | OM4/OS2 capacity planning for 25G/100G migration |
| Horizontal Cabling | Telecom room to endpoints (desks/AP/cameras) | Cat6A default for 10G + PoE++ thermal safety |
| Work Area | Outlets, patch cords, endpoint connectivity | Port labeling, channel test records, spare capacity |

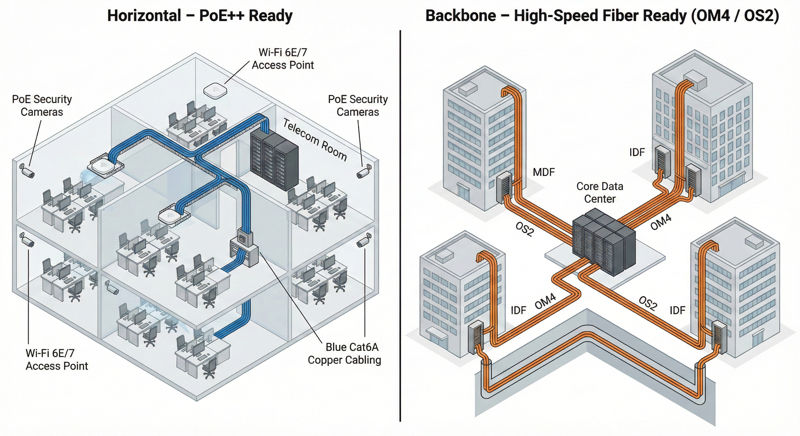

Most modern projects standardize on a hybrid architecture: Cat6A (or higher) for horizontal links and fiber for backbone. This splits the system by what each medium does best: copper for flexible device drops (including PoE), fiber for bandwidth and distance with clean upgrade paths.
| Layer | Common media (2026) | Typical use | Why it works |
|---|---|---|---|
| Backbone | OM4 / OS2 fiber | Room-to-room, floor-to-floor, building-to-building | Distance + bandwidth + upgrade headroom |
| Horizontal | Cat6A copper | Desk drops, APs, cameras, access control | 10G capable + supports PoE++ endpoints |
| High-density zones | Fiber (breakouts / MPO) + structured copper | Data center rows, IDF/MDF concentration points | Cable management + rapid moves/add/changes |

Use these shortcuts to avoid overbuilding (wasting budget) or underbuilding (forcing early replacement). The goal is to hit the right decision threshold for speed, power, and lifecycle.
| If your project has… | Default choice (2026) | Why | Risk if you choose lower spec |
|---|---|---|---|
| 10G access target, new office/campus build | Cat6A horizontal + labeled patching | Stability for 10G channels; better crosstalk margin | Early re-cabling for bandwidth; troubleshooting cost |
| Many PoE endpoints (APs/cameras/BMS) | Cat6A + bundle/thermal planning | PoE++ heat and voltage drop control | Overheating, link instability, shortened lifespan |
| Building-to-building or long backbone runs | OS2 backbone fiber | Distance + future 100G/400G readiness | Backbone bottleneck; costly civil work later |
| Data center / high-density distribution | OM4 + structured high-density (clean cable management) | Density + port growth + faster changes | Congestion, airflow issues, long MTTR |
Structured cabling requirements in 2026 are shaped by three forces: higher baseline speeds, PoE-powered edge devices, and higher density network rooms. If you design like it’s 2019, your cabling will age faster than your business plan.
Cabling decisions should be evaluated by total cost of ownership (TCO). The cable itself is often a smaller cost than the labor, downtime risk, and future retrofit disruption.
| Cost/Risk Factor | What increases it | How to reduce it (best practice) | Why it matters to procurement |
|---|---|---|---|
| Retrofit disruption | Underbuilding bandwidth/fiber count | Plan capacity for 5–10 years; add spare fibers/ports | Downtime and rework cost can exceed initial savings |
| Fault isolation time (MTTR) | Poor labeling, messy patching | Port maps + labels + test records as deliverables | Faster troubleshooting reduces operational expense |
| PoE thermal issues | High-power endpoints, large bundles, poor routing | Bundle planning, pathway spacing, quality cable selection | Prevents instability and premature replacement |
| Performance re-tests | Unclear acceptance criteria | Define channel tests and acceptance docs upfront | Avoid scope creep and disputes at handover |
Define target speeds (today + next refresh cycle).
Plan hybrid architecture: Cat6A horizontal + OM4/OS2 backbone.
Specify PoE endpoints and bundle/thermal assumptions.
Set acceptance criteria: labeling + port maps + test records.
Maintain bend radius and routing discipline (trays, ladders, conduits).
Separate power and data pathways where required.
Keep patching tidy; avoid “temporary” bundles that become permanent.
Label both ends consistently (rack → panel → outlet).
Deliver test reports (copper channel + fiber loss/OTDR if required).
Provide port maps, labeling schema, and as-built documentation.
Reserve spare ports/fibers for future expansion.
Document maintenance SOPs for move/add/change.

A 2026-ready structured cabling system is built for change: higher speeds, more endpoints, and more power at the edge. The most dependable approach for most projects is a Cat6A horizontal + OM4/OS2 fiber backbone architecture, delivered with disciplined labeling, testing, and as-built documentation. If you want to minimize downtime and avoid disruptive retrofits, define lifecycle targets early, plan capacity (ports/fibers/pathways), and treat documentation as part of the deliverable—not an afterthought.
