How to Plan Cable Orders Around MOQ, ETA, and Container Space

Author: Site Editor     Publish Time: 22-04-2026      Origin: Site

Cable Order Planning Guide

How to Plan Cable Orders Around MOQ, ETA, and Container Space

For cable buyers, MOQ, ETA, and container space are not separate checkpoints. They form one commercial and operational planning system. A good order structure should be producible, shippable, and aligned with the site schedule at the same time.

Procurement Teams Engineers Project Managers System Integrators International Buyers OEM / Project Orders
  • MOQ controls whether the order structure is practical for production, not just whether the supplier accepts it.

  • ETA should be planned backward from the required-on-site date, not forward from the PO date.

  • Container space affects freight efficiency, split-shipment risk, and landed cost per meter.

Why MOQ, ETA, and Container Space Must Be Planned Together

In cable procurement, many delivery and cost problems begin long before production starts. A buyer may focus only on meeting MOQ and forget shipping efficiency. Another buyer may try to optimize container loading but lose too much time waiting for consolidation. A third buyer may rush the order for schedule reasons but end up with a fragmented SKU structure that creates MOQ pressure, surcharge, or unstable planning.

For procurement teams, engineers, project managers, and system integrators, the real question is not only how many meters are needed. The more useful question is whether the order can be produced efficiently, shipped economically, and delivered in time for installation. That is why MOQ cable order planning, cable ETA control, and container planning cable decisions should be treated as one combined framework from the beginning of RFQ and PO review.

Key takeaway

A good cable order is not simply the one with the lowest unit price. It is the one that can move through specification approval, production, packing, shipment, and site delivery with the lowest total project risk.

Quick Decision Table

Planning Factor What It Controls Main Risk if Ignored What Buyers Should Confirm Early
MOQ Whether the order is economically and operationally feasible to produce Surcharge, spec merging, delayed production, forced quantity changes MOQ by cable type, color, construction, print, and packing method
ETA When goods can realistically arrive and be used on site Site delay, installation idle time, temporary substitute purchase, expediting cost Approval time, material lead time, production slot, testing, booking, transit, destination release
Container Space Freight efficiency and shipment feasibility Poor loading ratio, split shipment, wasted freight budget, late delivery Drum size, reel count, pallet method, container type, weight vs volume limit, mixed-SKU loading plan

What MOQ Means in Real Cable Orders

MOQ is often misunderstood as a simple commercial rule, but in cable manufacturing it is usually tied to real production logic. Conductor drawing, insulation extrusion, sheathing changeover, jacket color switching, meter marking, testing batch arrangement, and packaging setup all affect how small or fragmented an order can be without creating inefficiency or instability.

For standard products, MOQ pressure may be moderate. For customized constructions, branded jacket printing, special flame ratings, or non-standard drum lengths, MOQ becomes much more important. In practice, low total quantity is not always the main problem. Fragmentation is often the bigger issue.

MOQ Type What It Usually Applies To Buyer Impact
Per SKU MOQ One exact model or full specification Too many low-volume variants can make the order non-viable
Per Color MOQ Jacket or core color customization Custom color may block small-quantity approval
Per Packaging MOQ Drum length, pallet type, reel style Non-standard packing can push the threshold higher
Print / Label MOQ Private label, custom print legend, buyer-specific marking Branding requests may increase minimum order quantity
Combined Run MOQ Several compatible items arranged in one production run Can reduce MOQ pressure when specifications are close enough
Field reality

Ten small customized SKUs usually create more MOQ pressure than one larger standardized order with the same total volume.

What ETA Really Includes

Many buyers use ETA as if it means only vessel arrival. That is too narrow for cable orders. In practice, ETA should reflect the full chain from order confirmation to usable goods at destination. A schedule that ignores approval, testing, packing, booking, or customs timing is not a reliable delivery plan.

ETA Component What It Covers Common Hidden Delay
Technical Confirmation Final specification, drawing, color, print, and test requirement approval Repeated revisions and unclear approval comments
Material Preparation Copper, insulation, sheath compound, fiber, shielding tape, packaging Custom material or non-stock component lead time
Production Lead Time Twisting, extrusion, armoring, sheathing, meter marking, reel preparation Machine slot congestion or changeover impact
Testing and QC Routine test, batch inspection, QA record, document preparation Extra inspection request or pending sample approval
Packing and Loading Drum arrangement, palletizing, loading coordination Wrong drum assumptions or incomplete packing plan
Booking and Transit Vessel booking, port handling, sea transit Peak-season space shortage or shipment roll-over
Destination Release Customs clearance and inland delivery to site or warehouse Document mismatch or release timing issue

A reliable ETA model should be built backward from the required-on-site date. That means buyers should define the installation need first, then count backward through arrival, customs release, transit, booking, packing, QC, production, and technical confirmation.

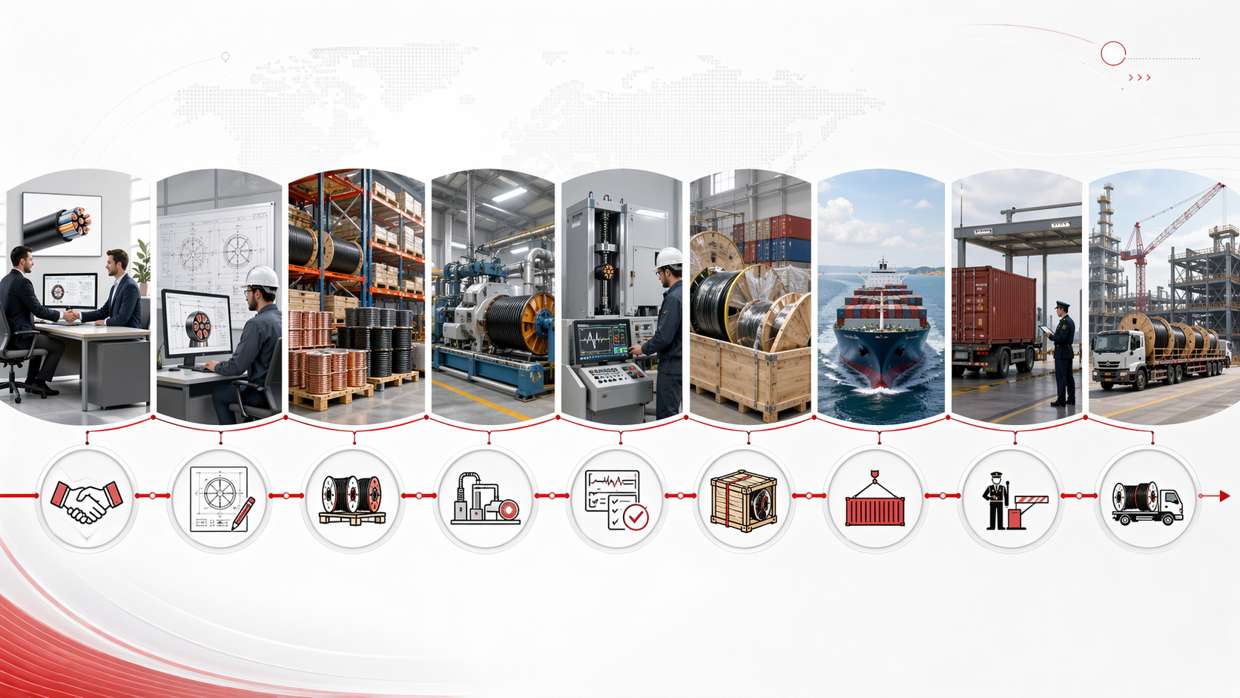

Cable ETA Planning Timeline

How Container Space Changes Order Economics

Container planning is often underestimated because buyers focus first on quantity and unit price. But cable is not a simple carton product. Reel diameter, reel width, weight concentration, pallet use, stacking limits, and safe loading pattern all affect how much product can actually move in one shipment.

Two cable orders with the same total meter quantity may require very different shipping space depending on cable diameter, conductor weight, packing length per drum, and whether the goods are volume-limited or weight-limited. That is why container planning should begin before PO confirmation, not after production is finished.

Buyers should request these loading inputs early
  • Estimated reel dimensions by item

  • Reel count and packing length per drum

  • Net and gross weight

  • Pallet or loose loading method

  • Estimated loading plan for 20GP, 40GP, or 40HQ

  • Whether the shipment is volume-limited or weight-limited

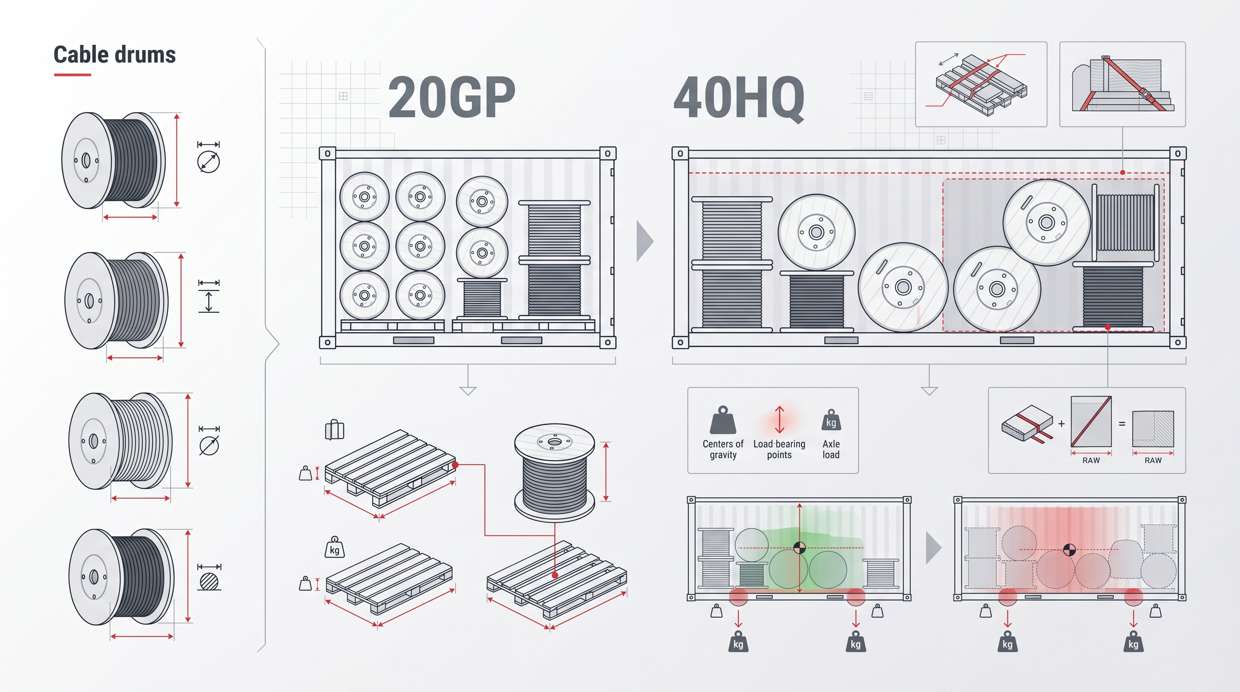

Container Planning for Cable Shipments

How to Balance MOQ, ETA, and Container Space

The best order plan is rarely the one optimized for only one variable. A full-container strategy may improve freight efficiency but create delivery delay. A fast partial shipment may protect the schedule but fall below reasonable MOQ. A customization-heavy structure may meet the engineering requirement but create avoidable production fragmentation.

Project Situation First Priority Second Priority Third Priority Recommended Planning Strategy
Standard replenishment order Container efficiency MOQ ETA Consolidate compatible SKUs and optimize loading ratio
Urgent project start ETA MOQ Container efficiency Lock standard specs, reduce optional customization, reserve production slot early
Multi-phase deployment ETA by phase MOQ Container efficiency Split delivery by installation logic while standardizing SKUs where possible
Custom OEM cable order MOQ ETA Container efficiency Freeze specifications early and avoid repeated changes
International mixed-SKU procurement Container efficiency + ETA MOQ Build the shipment around the container plan and booking window
Tender-backed order with fixed site schedule ETA Container efficiency MOQ Protect critical-path items first and separate non-critical items if required

When to Consolidate or Split the Order

Consolidation and split delivery are both valid planning tools. The correct choice depends on whether freight efficiency, production feasibility, schedule protection, or inventory control is more important for the project.

Condition Better to Consolidate Better to Split
Standard cable with stable project timing Yes No
Many low-volume custom SKUs Partly, if non-critical features can be standardized Yes, if project phases require different timing
Freight cost is a major concern Yes No
Site schedule is highly sensitive Only if ETA still fits Yes
MOQ pressure is high Yes, especially for compatible items Usually no
Critical-path items are much more urgent than others No Yes
Practical rule

Split by installation logic, not by arbitrary quantity. Consolidate by compatible production and loading logic, not by wishful freight assumptions.

Common Planning Mistakes

1. Quoting before the real specification is frozen

If conductor, shielding, sheath, color, print, or drum length are still changing, MOQ and ETA estimates are not stable.

2. Using one total quantity without phase logic

A project may need 50 km in total, but only 15 km for the first stage. Ordering everything at once can create stock pressure and wrong timing.

3. Ignoring drum dimensions until the end

Cable shipment efficiency depends heavily on reel size and packing method. Meter quantity alone does not predict loading efficiency.

4. Treating ETA as production time only

Real ETA includes approval, QC, packing, booking, transit, destination release, and site delivery timing.

5. Treating MOQ as negotiation only

Some MOQ thresholds reflect real material, setup, testing, and packaging economics. They are not always arbitrary.

6. Waiting too long to discuss booking strategy

A technically finished order can still miss the required delivery window if booking and container coordination start too late.

Engineer’s Shortcut

If This Is Your Situation Use This Rule
Your order includes many small custom variants Standardize non-critical features first
Your project start date is fixed Plan backward from site date, not vessel date
Your freight budget is tight Ask for a loading estimate before PO, not after production
Your order is below comfortable MOQ Merge compatible SKUs or reduce optional customization
Your project is phased Split delivery by installation logic, not by random quantity
Your cable is bulky or reel-heavy Validate drum dimensions and container plan early

When This Planning Model Matters Most

Prioritize MOQ when:

the order includes many custom details, low per-SKU volume, private labeling, special fire rating, or unusual packaging.

Prioritize ETA when:

the site schedule is fixed, installers are booked, or delayed cable arrival would block downstream work.

Prioritize container space when:

the shipment is export-based, freight cost is material, or multiple SKUs must move in one consolidated load.

When to choose this planning method

This framework is especially useful for export orders, mixed-SKU projects, OEM customization, tender-backed schedules, and any order where cable drums, site timing, and freight efficiency all influence commercial outcome.

FAQ

What is the most common reason MOQ becomes a problem in cable orders?
Usually it is not the total order size. The bigger problem is fragmented specifications, such as too many colors, prints, drum lengths, or low-volume custom constructions.
Should buyers always wait for a full container before shipping cable?
No. Full-container efficiency matters, but not when it causes site delay or pushes critical items beyond the required arrival window. Freight efficiency should be balanced against schedule risk.
Is ETA the same as lead time?
No. Lead time usually refers to a part of the process, such as production. ETA should reflect the full chain until the goods are expected to arrive and become usable.
Can MOQ be reduced?
Sometimes yes, especially if non-critical customization is reduced, compatible items are merged, or the order is part of a broader repeat-demand plan. But not every MOQ can be negotiated away.
Why does container planning matter so much for cable?
Because cable is often shipped on reels or drums, and freight efficiency depends on reel dimensions, weight distribution, pallet method, and loading pattern rather than meter quantity alone.
When should container planning start?
Before PO confirmation. Once drum size, packing method, and loading assumptions are fixed late in the process, the buyer usually has less flexibility and more risk.

Conclusion

Cable order planning works best when MOQ, ETA, and container space are treated as one connected decision framework. MOQ shows whether the order structure is commercially and operationally realistic. ETA shows whether the goods can support the project schedule. Container planning shows whether the shipment can move efficiently and economically. Buyers who optimize only one variable often create cost, delay, or inventory problems somewhere else.

For procurement teams, engineers, and project managers, the practical goal is not only to place the order. It is to build an order structure that can be approved, produced, packed, shipped, and installed with the lowest total project risk.

Need help reviewing MOQ, ETA, or shipment structure for your next cable order?
ZION can help you evaluate specification compatibility, production practicality, shipment planning, and packing logic before PO release.

  • [Security&Fire Protection] FPLP Fire Alarm Cable: What It Is and When to Use It
    Learn what FPLP fire alarm cable is, how it differs from FPLR and FPL, and when plenum-rated fire alarm cable is the right choice for compliant building installations. Read More
  • [Cable Buyer Guide] How to Plan Cable Orders Around MOQ, ETA, and Container Space
    Cable Order Planning GuideHow to Plan Cable Orders Around MOQ, ETA, and Container SpaceFor cable buyers, MOQ, ETA, and container space are not separate checkpoints. They form one commercial and operational planning system. A good order structure should be producible, shippable, and aligned with the Read More
  • [Cable Buyer Guide] Batch Test Certificate vs Type Test Report: What Is the Difference?
    Learn the difference between a Batch Test Certificate and a Type Test Report in cable procurement. Understand when each document is needed, what risks they control, and how buyers, engineers, and project teams should use both for compliance and delivery approval. Read More
We use cookies to enable all functionalities for the best performance during your visit and to improve our services by giving us some insight into how the website is being used. Continued use of our website without changing your browser settings confirms your acceptance of these cookies. For details, please see our privacy policy.
×
