A practical decision guide for engineers, procurement teams, project managers, and system integrators who need to turn ETD and ETA into reliable cable delivery plans instead of risky assumptions.
Plan from the required on-site ready date backward, not from a quoted ETA forward.
Separate production lead time, ETD, transit, customs, receiving inspection, and internal release.
For customized or critical-path cable orders, freeze specs earlier and build larger schedule buffers.
For cable buyers, ETD and ETA are not simple logistics labels. They are planning variables that affect installation dates, project sequencing, inventory pressure, emergency freight cost, and supplier coordination. A reliable cable order plan starts from the date the goods must be accepted and usable on site, then works backward through receiving, customs, transit, ETD, production lead time, and technical approval. This is especially important for customized, compliance-sensitive, or project-critical cable orders where even a small timing error can trigger labor disruption, resequenced installation, or avoidable delay claims.
In real projects, delivery timing controls more than transport. It affects whether the cable arrives before tray closure, equipment commissioning, civil handover, or structured cabling cutover. A late shipment may also leave site labor idle, force temporary rework, or require premium freight to recover the schedule.
That is why engineers, procurement teams, and project managers should not treat ETD or ETA as isolated dates. The more useful control point is the date when the cable is actually received, checked, released, and ready for installation.
A shipment can meet ETA and still fail the project if customs, receiving inspection, print marking checks, reel quantity checks, connector verification, or internal release are not included in the schedule.

ETD usually means Estimated Time of Departure. In cable procurement, it is the expected date when the goods leave the port, airport, or shipping point after production, testing, packing, and export preparation are completed.
ETA usually means Estimated Time of Arrival. It is the expected date when the shipment reaches the destination port, airport, or receiving point. It is not automatically the same as the on-site ready date.
| Term | What it means | What it does not mean | Why buyers care |
|---|---|---|---|
| ETD | Expected departure date after goods are ready and booked | Factory start date or guaranteed completion date | Shows whether factory-side and booking-side progress are aligned |
| ETA | Expected arrival date at destination | Final installation-ready date | Helps coordinate customs, receiving, warehouse handling, and site sequence |
| Production lead time | Time to manufacture, test, pack, and prepare documents | Shipping transit time | Determines how early the PO must be released |
| Usable on-site date | Date when cable is received, checked, and ready for installation | ETA by itself | This is the real project control milestone |

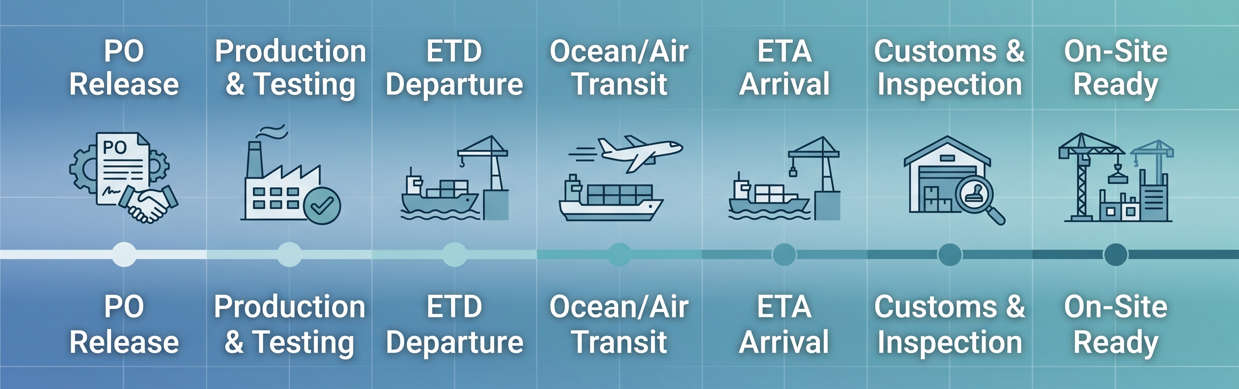

The safest way to plan cable orders is backward scheduling. Start from the date when the cable must be accepted and usable on site, then subtract receiving time, customs and inland transfer, transit, ETD target, and production lead time. Only after that should you set the latest safe PO release date.
This method is more reliable than simply asking whether the supplier can “deliver by” a target date, because it separates production risk from logistics risk and forces the team to freeze technical details early enough.
| Planning step | What to calculate | Practical control question |
|---|---|---|
| Required installation date | When the cable must actually be used | Is this the true installation date or only a project target? |
| Usable on-site date | Add unloading, receiving, and inspection time | Does the site need the goods before the cable crew arrives? |
| Destination buffer | Add customs and local transfer margin | Is import clearance predictable in this country or project zone? |
| ETA target | Latest acceptable arrival date | What happens if arrival slips by 3 to 7 days? |
| Transit window | Choose sea, air, rail, courier, or mixed mode | Is cost or schedule certainty more critical for this order? |
| ETD target | Latest safe departure date | Has actual booking capacity been considered? |
| PO release date | Latest safe order release date after spec freeze | Are drawings, print marking, compliance documents, and packing rules all confirmed? |
Do not manage a cable project against ETA alone. Manage it against the date the goods can be received, checked, and released for actual installation.
Not all cable orders carry the same schedule risk. A standard repeat item is easier to plan than a custom fiber optic cable, an armored outdoor cable, a fire-resistant cable, or a project-specific structured cabling batch that needs print marking approval, compliance documents, or special reel and packaging requirements.
| Factor | Lower-risk case | Higher-risk case | Planning impact |
|---|---|---|---|
| Product type | Standard patch cords, common LAN cable, repeat fiber cable | Armored, fire-resistant, hybrid, or project-specific assemblies | Complex products need longer production and release windows |
| Customization level | Standard length, color, and package | Custom marking, labeling, reel size, conductor, sheath, or structure | More approvals mean more pre-production risk |
| Compliance requirement | Basic commercial shipment | Tender documents, fire class, certification, project reports | Document and testing cycles can delay release |
| Order volume | Small repeat order | Large project batch | Capacity reservation becomes more important |
| Shipping mode | Direct courier or air | Sea freight with transshipment | Transit variability increases |
| Destination environment | Predictable customs and inland transfer | Complex import control or remote inland delivery | Arrival-side buffer should be larger |
Instead of asking whether a promised delivery date looks acceptable, use decision thresholds. This helps engineering and procurement teams choose the right order timing, shipping method, and risk buffer based on project reality.
| Situation | When to choose this approach | When not to rely on it | Alternative | Cost / risk / maintainability effect |
|---|---|---|---|---|
| Plan around standard ETD + ETA | Repeat orders, stable routes, flexible site schedule | Critical-path project materials or uncertain customs conditions | Add milestone tracking and larger receiving buffer | Lower coordination effort, but weaker protection against disruption |
| Freeze specs before PO and book early | Custom construction, special print marking, project packaging | If internal approvals are still changing | Delay PO intentionally, but accept schedule compression | Better schedule reliability, lower mismatch risk after release |
| Use split shipment | Part of the order is critical and site work can start in phases | If all items are equally urgent or coordination is weak | Ship full batch together with larger overall buffer | Higher freight cost, but often protects the critical path |
| Use airfreight recovery | Schedule is slipping and delay cost exceeds premium freight cost | Large, heavy, low-value cable volumes with flexible deadlines | Air only for urgent balance or first-stage reels | Fast recovery, but cost can rise sharply |
| Manage against usable on-site date | Projects with strict installation sequence or acceptance control | Never inappropriate; this is usually the safest method | None better for project control | Best visibility across procurement, logistics, warehouse, and site teams |

Cable buyers often want the lowest freight cost, the shortest lead time, and the smallest inventory window at the same time. In practice, procurement teams must balance freight cost, inventory cost, and delay cost. For critical projects, the hidden cost of a late cable shipment may be much higher than the visible cost of earlier booking or faster transport.
| Planning choice | Main benefit | Main cost or risk |
|---|---|---|
| Order early and use sea freight | Lower freight cost and lower emergency risk | Longer inventory holding time |
| Order late and use sea freight | Lower inventory window | Higher schedule risk and weaker recovery options |
| Use full airfreight | Fastest recovery if the timeline is slipping | High freight cost |
| Split shipment | Protects early installation stages | More coordination and document handling |
| Hold safety stock for repeat items | Better response speed for recurring demand | Capital tied up in inventory |
A good delivery commitment is based on controlled milestones rather than optimistic assumptions. Before confirming the order plan, buyers should ask a few practical questions that reveal whether the quoted ETD and ETA are realistic.
Is the quoted lead time based on current capacity or only a normal estimate?
Does the lead time include testing, print marking confirmation, and export packing?
Is ETD linked to an actual booking window or only a provisional plan?
What could delay ETD after production is completed?
Does ETA depend on direct routing or transshipment?
What import or project documents must be ready before arrival?
Can the shipment be split if one part becomes critical?
Which details must be frozen before production starts?
Are there material constraints that could change the lead time?
What is the latest safe PO date to support the required on-site ready date?
For project-driven cable orders, supplier support should go beyond price quotation. Buyers also need clear visibility into production scope, customization boundaries, packing rules, documentation needs, and realistic shipment timing. ZION Communication can support this planning process by aligning technical specifications, quantity structure, marking and packaging requirements, and target delivery milestones early, so ETD and ETA are managed as part of the full project schedule rather than treated as isolated logistics terms.
Planning cable orders around ETD and ETA is really about controlling delivery risk from end to end. The strongest method is to work backward from the date the cable must be accepted and usable on site, then account for receiving, customs, transit, ETD, production lead time, and technical freeze. Buyers who manage only to ETA often discover problems too late. Buyers who manage to the full delivery chain make better decisions on PO timing, shipping mode, schedule buffer, and supplier coordination.
