HOME » News / Blog » Security&Fire Protection » When Is PH120 Cable Required in Fire Survival Circuits? | Fire Survival Cable Selection Guide

When Is PH120 Cable Required in Fire Survival Circuits? | Fire Survival Cable Selection Guide

Author: Site Editor     Publish Time: 14-04-2026      Origin: Site

Fire Survival Cable Selection Guide

When Is PH120 Cable Required in Fire Survival Circuits?

PH120 cable is usually required only when the circuit must keep operating for up to 120 minutes during a fire, especially in UK / BS-based firefighting, smoke control, phased evacuation, or other extended life-safety applications. It is not the default answer for every fire alarm or emergency lighting circuit.

Engineers Procurement Teams Project Managers System Integrators Fire Protection Contractors Consultants
  • PH120 is typically selected when the circuit must survive for 120 minutes, not simply because the project is “fire rated.”

  • Its strongest use case is extended life-safety or firefighting operation, such as smoke control, firefighting lifts, and some complex evacuation strategies.

  • Always specify the full application path and installation system, not just the phrase “PH120 cable.”

For engineers, buyers, and contractors, the real question is not “Is this a fire survival circuit?” but “How long must this circuit remain operational, and for what function?” In UK / BS-based design practice, PH120 is normally reserved for applications where the circuit must continue to support life safety or firefighting functions for up to two hours. That makes PH120 a strategy-driven selection, not a universal upgrade. If the building fire strategy, evacuation profile, occupancy pattern, or firefighting function does not justify 120-minute survival, specifying PH120 everywhere can increase cost without improving practical compliance.

1) What PH120 Means in Practice

PH120 is a survival-time class, not a complete specification

PH120 generally indicates that a cable is intended for circuits that need to maintain function during fire exposure for up to 120 minutes. In real projects, that should not be treated as a standalone purchasing shortcut. The design still needs to define the application category, the relevant standard path, and whether the entire cable system—including supports, joints, containment, and routing—can actually maintain operation for the same duration.

Field reality / Practical rule
In fire survival projects, a higher cable grade alone does not guarantee system survival. If the cable tray, clips, glands, joints, or terminations fail earlier than the cable itself, the circuit still fails.
Term Practical meaning What it does not mean
PH120 Cable selected for circuits requiring extended operational survival under fire conditions, typically up to 120 minutes Not proof that every project or every fire alarm loop needs it
Enhanced fire survival Used where evacuation, firefighting, or building operation continues for longer and needs more resilient circuits Not the default requirement for ordinary applications
Cable system Cable + supports + joints + fixings + routing + terminations Not just the cable core and sheath

What PH120

2) When PH120 Is Required

Use PH120 when the circuit must remain functional for extended life-safety operation

The clearest engineering trigger is simple: the circuit must continue operating for up to 120 minutes during a fire event. In UK / BS-based projects, this is most commonly associated with firefighting-related circuits, complex unsprinklered buildings, phased evacuation strategies, or systems that must keep working while firefighters are still actively using the building.

Key takeaway
PH120 is a function-based selection. Choose it when the building strategy depends on two-hour circuit survival, not just because “more fire resistance sounds safer.”
Project condition Why PH120 may be required Typical decision outcome
Firefighting control circuits System must remain available while firefighting is underway PH120 strongly indicated
Smoke control / smoke extraction / SHEVS-related control Smoke management often needs to continue beyond initial evacuation PH120 commonly selected
Firefighting lift-associated control or communication circuits Lift-related systems may need continued availability for fire service use PH120 often required
Unsprinklered building with long phased evacuation Circuit survival window may exceed standard fire alarm duration Enhanced selection often justified
High-rise or remote occupied zones during incident Critical signal paths may need to keep operating while other areas remain in use PH120 may be justified by design assessment
Project fire engineering report explicitly calls for 120-minute survival The design basis already defines the performance duration Specify PH120 route

Where PH120 Cable Is Critical

3) When PH120 Is Usually Not Required

Do not use PH120 as a default for every life-safety cable package

Many ordinary fire alarm and emergency lighting installations do not need two-hour circuit survival. In standard commercial, residential, retail, or light industrial projects, the applicable design path often points to a lower survival class. In those cases, PH120 may add cost, increase stiffness, complicate installation, and create an unnecessary procurement burden without reducing actual project risk.

Field reality / Practical rule
If the project brief says only “fire alarm cable” or “emergency lighting cable,” that is not enough information to jump to PH120. First confirm the required function duration, building type, evacuation logic, and local code path.
  • Ordinary fire alarm loops in typical buildings are often not PH120 applications.

  • Routine emergency lighting circuits are often not PH120 applications.

  • Low-risk projects without prolonged evacuation, firefighting dependence, or extended occupied remote areas usually do not need PH120.

  • Projects that cannot maintain system-level survival through supports and joints gain little value from specifying a higher cable class alone.

4) PH30 vs PH60 vs PH120

Choose the survival grade that matches the circuit duty, not the biggest number available

The most useful way to compare these grades is to focus on function duration. Higher grades can be necessary, but they are also more likely to affect material cost, stock strategy, termination practice, and installation planning.

Grade Typical survival logic Typical project use Commercial impact
PH30 Shorter survival window for basic fire alarm or escape-related operation Basic life-safety signaling where long continued operation is not required Lower cost, simpler stocking, easier to justify in routine projects
PH60 Intermediate survival duration for systems needing longer operational continuity Many emergency lighting or medium-duty safety applications Balanced option where PH30 is insufficient but PH120 is not justified
PH120 Extended survival window for prolonged evacuation or firefighting duty Smoke control, firefighting circuits, complex high-risk buildings, strategy-driven critical control Higher material and installation demand, but necessary when two-hour performance is part of the design basis

5) Typical Systems That Drive PH120 Selection

PH120 usually appears where building control must continue after initial evacuation starts

This is where the engineering logic becomes practical. If the circuit supports a system that must still operate while smoke is being managed, firefighters are entering the building, or evacuation is continuing in phases, PH120 becomes much easier to justify.

Smoke Control Systems
Fans, dampers, and smoke exhaust control circuits may need extended survivability because they directly affect visibility, tenability, and firefighting conditions.
Firefighting Lift Circuits
Associated control or communication circuits often require higher survival performance because the lift may remain part of the firefighting strategy.
Extended Evacuation Buildings
Unsprinklered high-rise or multi-stage evacuation projects may need longer circuit integrity to support orderly evacuation beyond the early fire stage.
Critical Remote Occupancy Zones
Hospitals, campuses, transport hubs, and large industrial sites may depend on longer-lasting signal paths serving areas remote from the initial fire.

6) Common Specification Risks

Most PH120 mistakes come from incomplete design logic, not from the cable itself

The most expensive errors usually happen when teams over-specify, under-define, or isolate the cable from the rest of the system design. That creates avoidable cost, procurement confusion, and tender-stage disputes.

Common mistake Why it happens Project consequence Better practice
Using PH120 for every life-safety cable Teams assume higher grade is always safer Higher cost and unnecessary complexity Match grade to actual function duration
Specifying only “PH120 cable” Tender language is too short or copied Ambiguity in approval and product substitution State application, duration, and full compliance route
Ignoring cable supports and joints Focus stays on cable datasheet only System fails earlier than expected Specify fire-rated support and matching accessories
Applying one market’s terminology globally International projects mix code systems Misalignment with local authority requirements Confirm country-specific fire cable classification path
Upgrading cable without checking installation conditions Routing, bending, space, and terminations are not reviewed Installation delays or poor workmanship risk Review layout, support spacing, and termination method early

7) Engineer’s Decision Table

A fast selection shortcut for engineers and buyers

Question If YES If NO
Does the design require circuit operation for up to 120 minutes in fire? PH120 route is likely appropriate Review PH60 or PH30 path instead
Is this a firefighting, smoke control, or other prolonged operational circuit? PH120 often justified or required Do not assume PH120 automatically
Is the building unsprinklered, high-rise, or using long phased evacuation? Enhanced survival may be needed Standard route may be sufficient
Will remote occupied areas depend on the circuit during the incident? Longer survival becomes more defensible Lower class may still comply
Have the supports, joints, and accessories been matched to the same fire survival target? The system can be specified with more confidence The cable grade alone does not solve the project risk

8) Procurement & Project Checklist

What to confirm before issuing a datasheet request or purchase order

1. Application
Fire alarm, emergency lighting, smoke control, firefighting lift, fire pump, voice alarm, or other control circuit
2. Required survival time
30, 60, or 120 minutes based on the design basis and building fire strategy
3. Standard path
Country-specific fire cable standard, project specification, and authority approval path
4. Cable construction
Conductor size, core count, voltage rating, shield, LSZH sheath, armoring, and installation environment
5. Installation method
Tray, conduit, trunking, vertical riser, exposed route, bending constraints, and fixation method
6. System accessories
Fire-rated clips, glands, joints, supports, terminations, and route segregation requirements

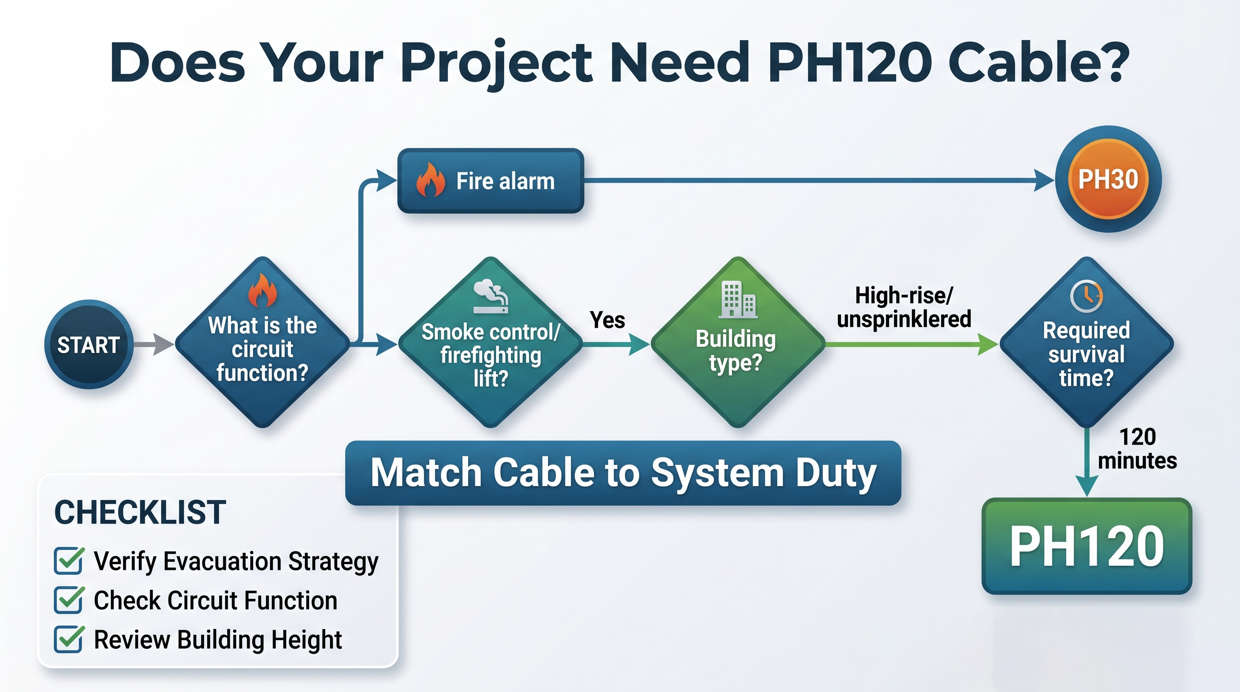

Does Your Project Need PH120 Cable

9) FAQ

Answers to the questions buyers and specifiers ask most often

Is PH120 cable required for every fire alarm circuit?
No. Many ordinary fire alarm systems do not need two-hour circuit survival. PH120 is usually selected only when the fire strategy, building profile, or applicable standard demands extended circuit function.
Is PH120 the same thing as “better fire cable”?
Not necessarily. It is a higher survival class for specific duty conditions. It is better only when the project truly requires the longer survival time.
What systems most often need PH120?
Smoke control, firefighting lift-associated circuits, and other extended-operating life-safety or firefighting systems are the most common drivers.
Can I specify only “PH120 cable” in a tender?
That is usually too vague. A better specification also defines the application, required survival time, standard path, and the need for matching fire-rated installation accessories.
What information should I send a supplier before asking for a quote?
Share the application, required fire survival duration, relevant standard, conductor size, core count, shield / armor needs, installation route, and whether accessories and supports must match the same fire performance class.

10) Conclusion

PH120 cable is required when the design basis calls for 120-minute circuit survival during a fire, especially in applications tied to firefighting operation, smoke control, prolonged evacuation, or other critical life-safety functions. It should not be treated as the default choice for all fire alarm or emergency lighting projects. The most reliable engineering approach is to match the cable class to the real duty of the circuit, verify the local standard path, and specify the entire cable system—including supports, joints, and installation method—so that the project performs as intended in an actual fire scenario.

Need the right PH120 cable for your project?

Send your project parameters, such as application type, required fire survival time, conductor size, core count, shield or armor requirement, voltage rating, installation route, and target standard. ZION can help match the cable construction and accessory path to your project specification.
